Client

City of Springfield

Location

Springfield, TN

Services

Wastewater Engineering

In Springfield, Tennessee, the city’s deteriorating wastewater collection system was impeding the community’s economic vitality. Between 2006 and 2011, the Springfield Water and Wastewater Department (SWWD) reported over 400 sanitary sewer overflows (SSOs) to the Tennessee Department of Environment and Conservation. In 2012, the City of Springfield negotiated an Administrative Order on Consent (AOC) with the United States Environmental Protection Agency (EPA), which mandated that the City eliminate the SSOs in their wastewater collection system within a five-year period.

Helping set the stage for long-term success through stronger infrastructure, the Springfield Administrative Order on Consent and Overflow Abatement Program provides a systematic approach for bringing the municipality into compliance while positioning Springfield as a more sustainable and healthy environment for the greater community.

52
miles of sewer will be improved by the end of the program
100
the average number of overflows per year that will be prevented within the city through improvements
2

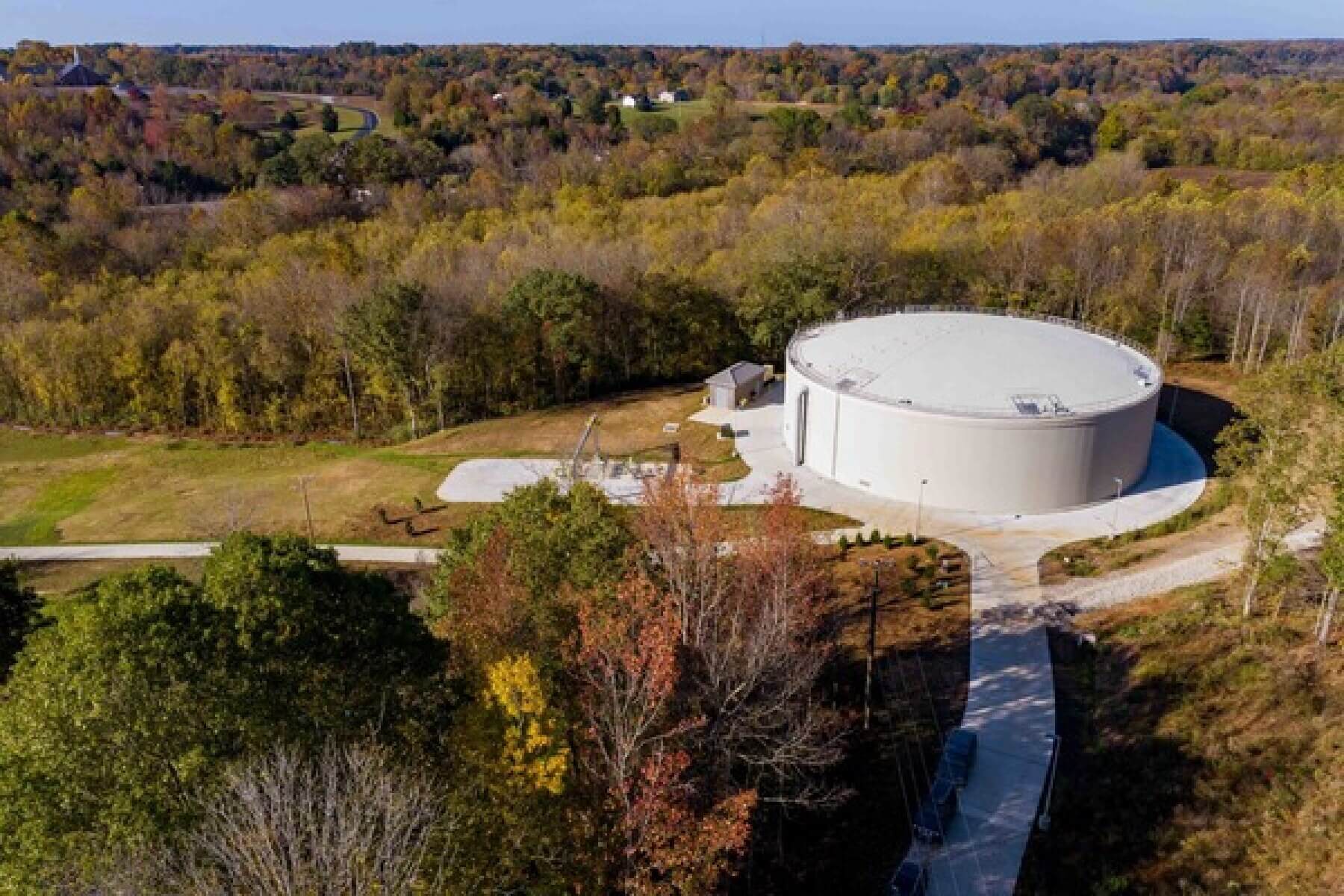

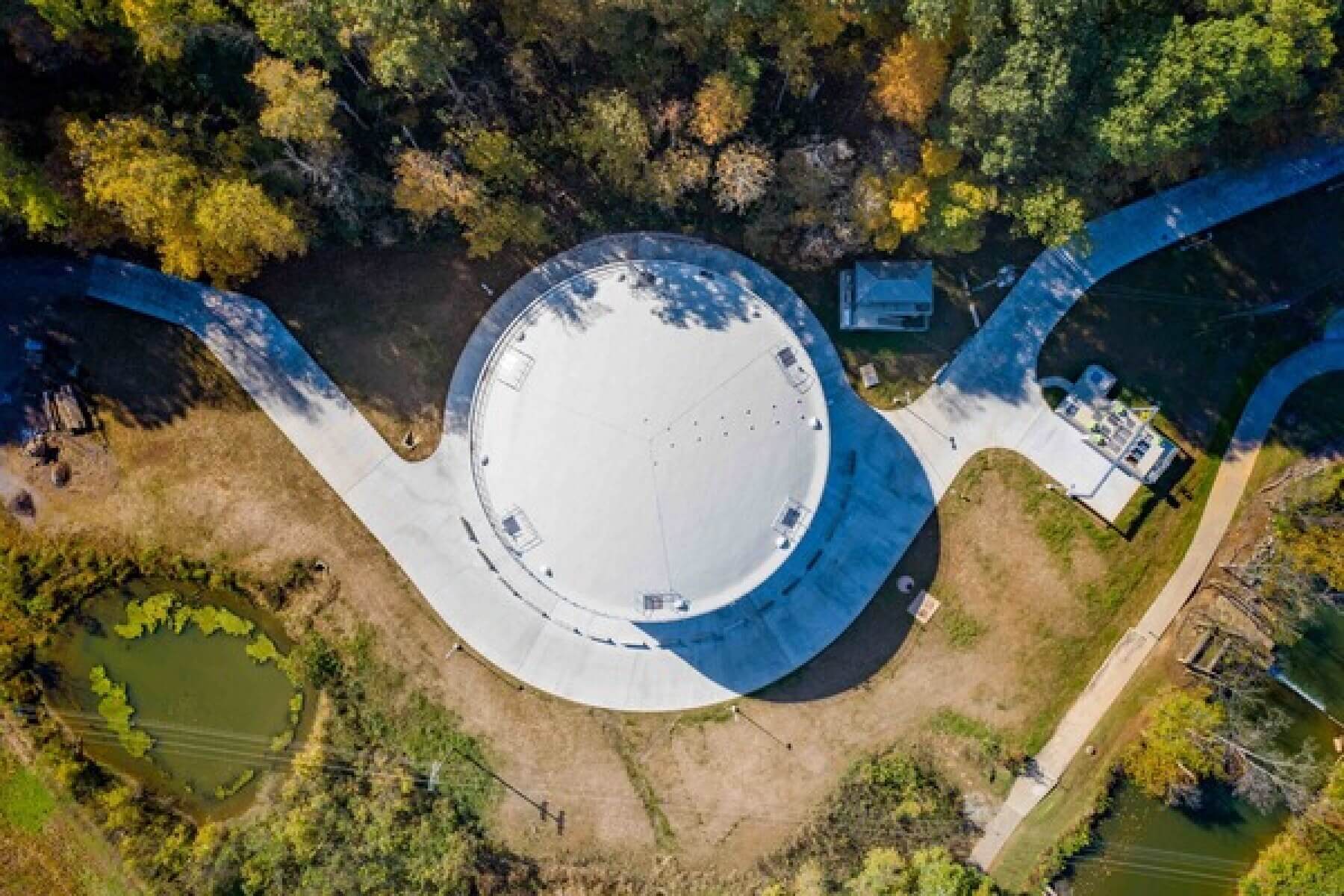

storage tanks to be constructed

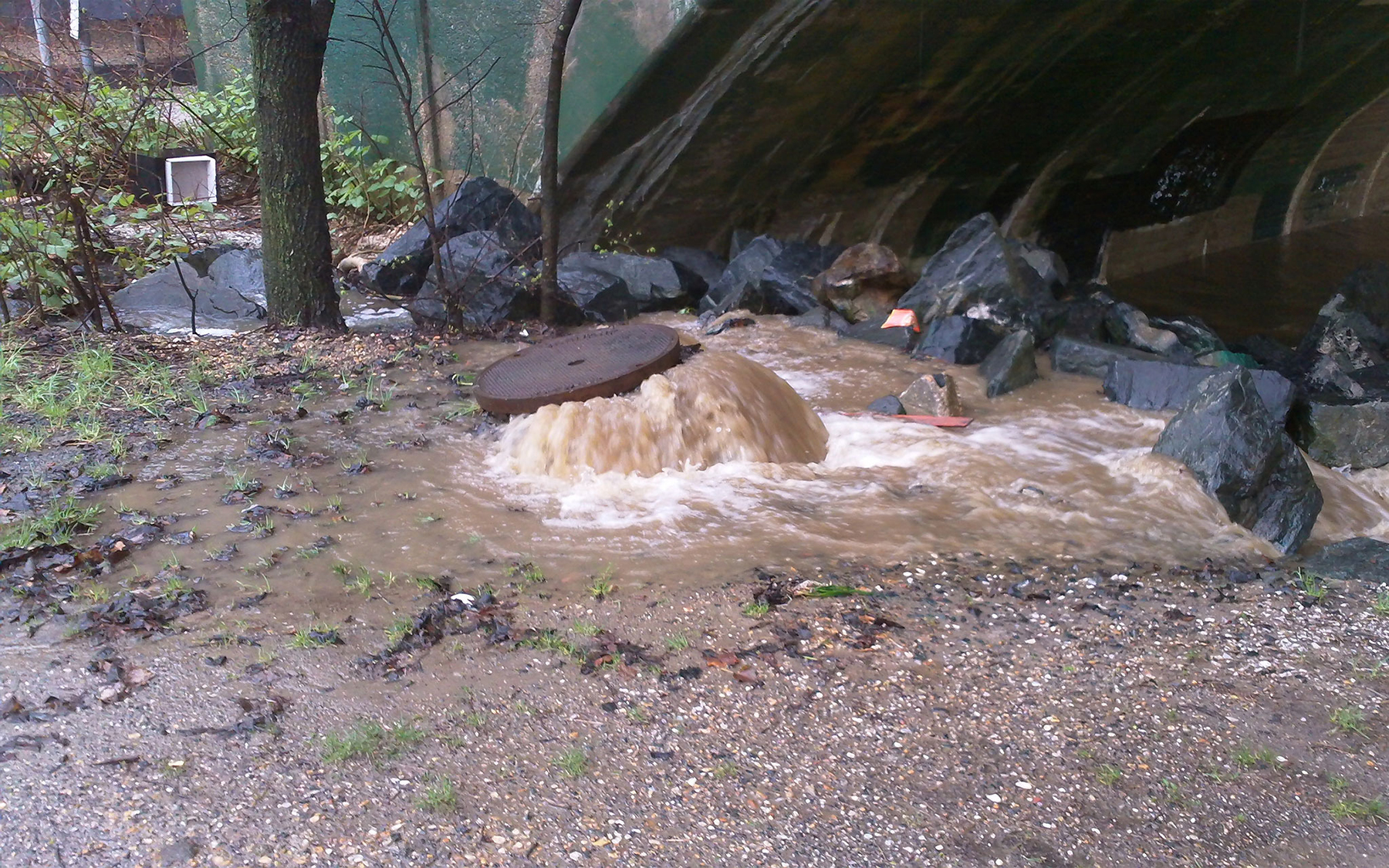

Image of inside the sewer from a closed-circuit TV video.

Major Repairs

Repairing the 140-mile sanitary sewer system became one of the City’s highest priorities. To meet the five-year schedule, construction required to eliminate the overflows had to be executed concurrently with the development and implementation of various plans and programs stipulated by the AOC. Gresham Smith was retained by the City to help develop this multitude of plans and programs, and to design and manage the projects to be constructed within the AOC.

Worker in a protective vest holding a tablet

Powering Up the Project With GPS

When Gresham Smith engineers began working with the SWWD, they relied on staff knowledge and AutoCAD maps of the collection system. The team immediately recognized that the SWWD needed a GIS-centric database for the collection and storage of the vast amounts of existing and new information necessary to make the SWWD a compliant and more robust utility. This information included physical data for the sewer pipes, record drawings, reported overflows, manhole inspection reports and photographs, rainfall data and sewer-flow monitoring data. The resulting GIS database serves as the basis of a long-term asset management program that allows the utility to shift from reactive repairs to proactive maintenance and replacement, which can be budgeted and anticipated.

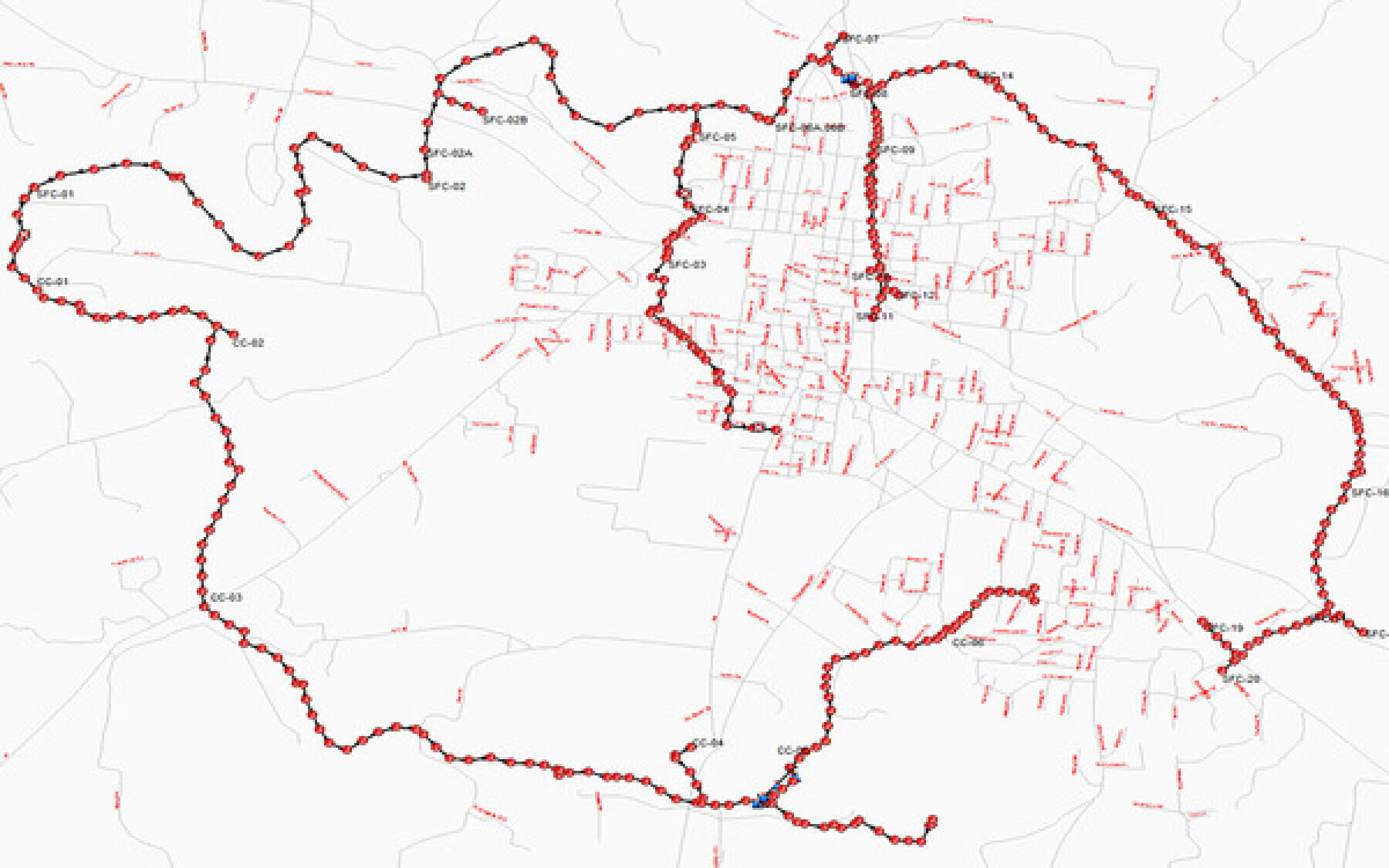

Gresham Smith also utilized the GIS database to build a computerized hydraulic model of the wastewater collection system. The model has the capacity to characterize the existing system and assess current flows, evaluate improvement projects, and plan expansions for future growth and development. Both the GIS database and the hydraulic sewer model served as vital tools in the development and implementation of a methodical process for the elimination of SSOs.

An Optimized Approach

We utilized the hydraulic model to conduct an alternatives analysis and evaluate improvement options. The analysis showed that no single solution would cost-effectively address the complex, systemwide issues. Instead, the examination revealed that the optimal solution involved a combination of remediation methods.

Gresham Smith proceeded with a system-specific approach that comprises rehabilitating portions of the existing sewers, improving conveyance by constructing new sewers where needed, and constructing two wastewater storage facilities in the collection system. This combination of remediation methods proved the best solution because it reduces rainfall-induced flows into the system, maximizes system storage, and improves system capacity while minimizing costs to the utility.

Increasing Capacity

Because of Highway 280’s prominence and the high volume of traffic, the backfill from the subgrade to the paving needed to be immaculate. Eighteen vertical feet of backfill was compacted, sloped and filled to exact specifications, creating a smooth roadway with no sign of sewer repairs in sight. Thanks to quick action and a strong network, our team helped safeguard the City of Hoover’s essential infrastructure.
