The I-40 Donelson Pike interchange relocation and reconstruction project reimagined one of Nashville’s most critical transportation gateways, improving safety, efficiency and direct access to Nashville International Airport (BNA). To accommodate record-breaking passenger growth and BNA’s multi-billion-dollar expansion, Gresham Smith led the design of this transformational project with a diverging diamond interchange (DDI) that reduces conflict points, improves traffic flow and creates an eastbound I-40 connection directly from the airport. The project also included a 1.5-mile collector-distributor road to eliminate weaving on I-40, four new bridges, and the repurposing of the former Donelson Pike bridge to include a dedicated pedestrian walkway. Constructed 13 months ahead of schedule through close collaboration with TDOT, the Metro Nashville Airport Authority, the Federal Aviation Administration and utility owners, the project is a model of innovation and teamwork. It establishes a safer, more efficient connection that supports future growth and enhances the traveling public’s experience.

132
acre construction site
4
new bridges
33%
projected reduction in crashes on Donelson Pike
7%
projected reduction in crashes along I-40

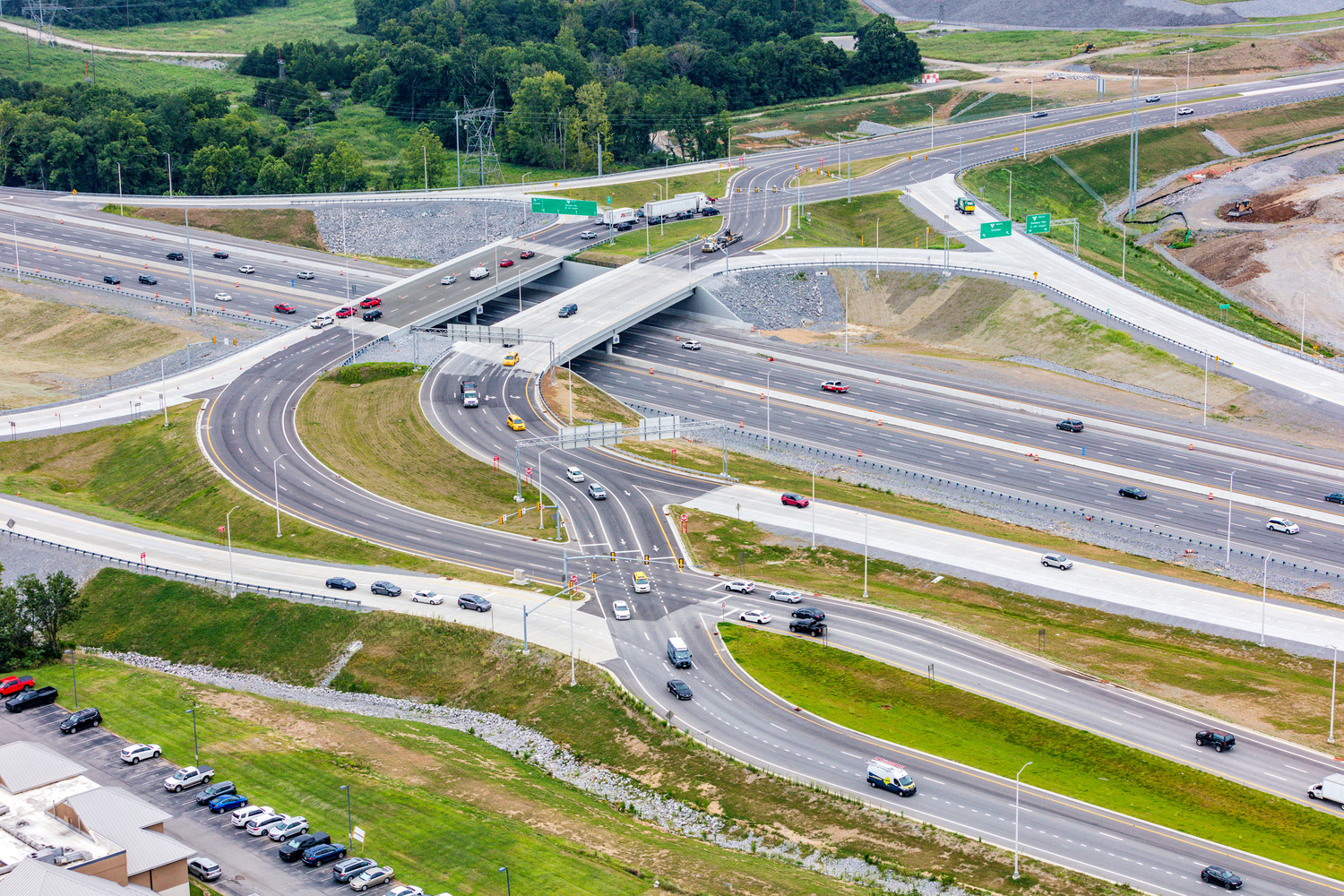

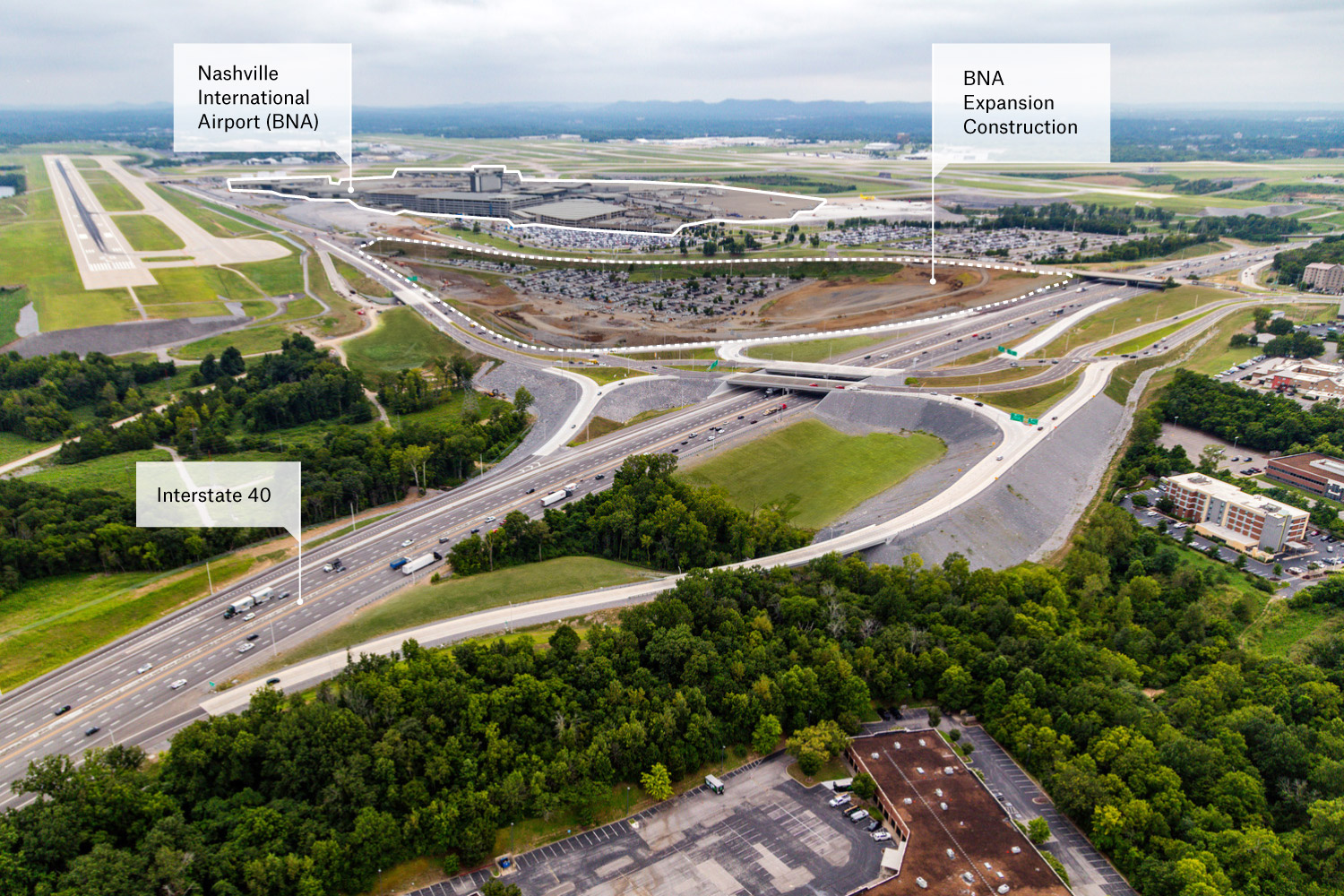

The completed diverging diamond interchange near the Nashville International Airport

The existing I-40 interchange at Donelson Pike was originally built in the 1980’s to provide access to a new airport terminal. BNA has been a major contributor to the rapid growth of the area, generating high volumes of both cargo and passenger traffic. During peak hours, the former interchange suffered from heavy congestion and delays. To address these challenges, our team proposed a diverging diamond solution, which over time is expected to lead to projected safety benefits including a 33% reduction in crashes on Donelson Pike and a 7% reduction on I-40.

The completed diverging diamond interchange near the Nashville International Airport

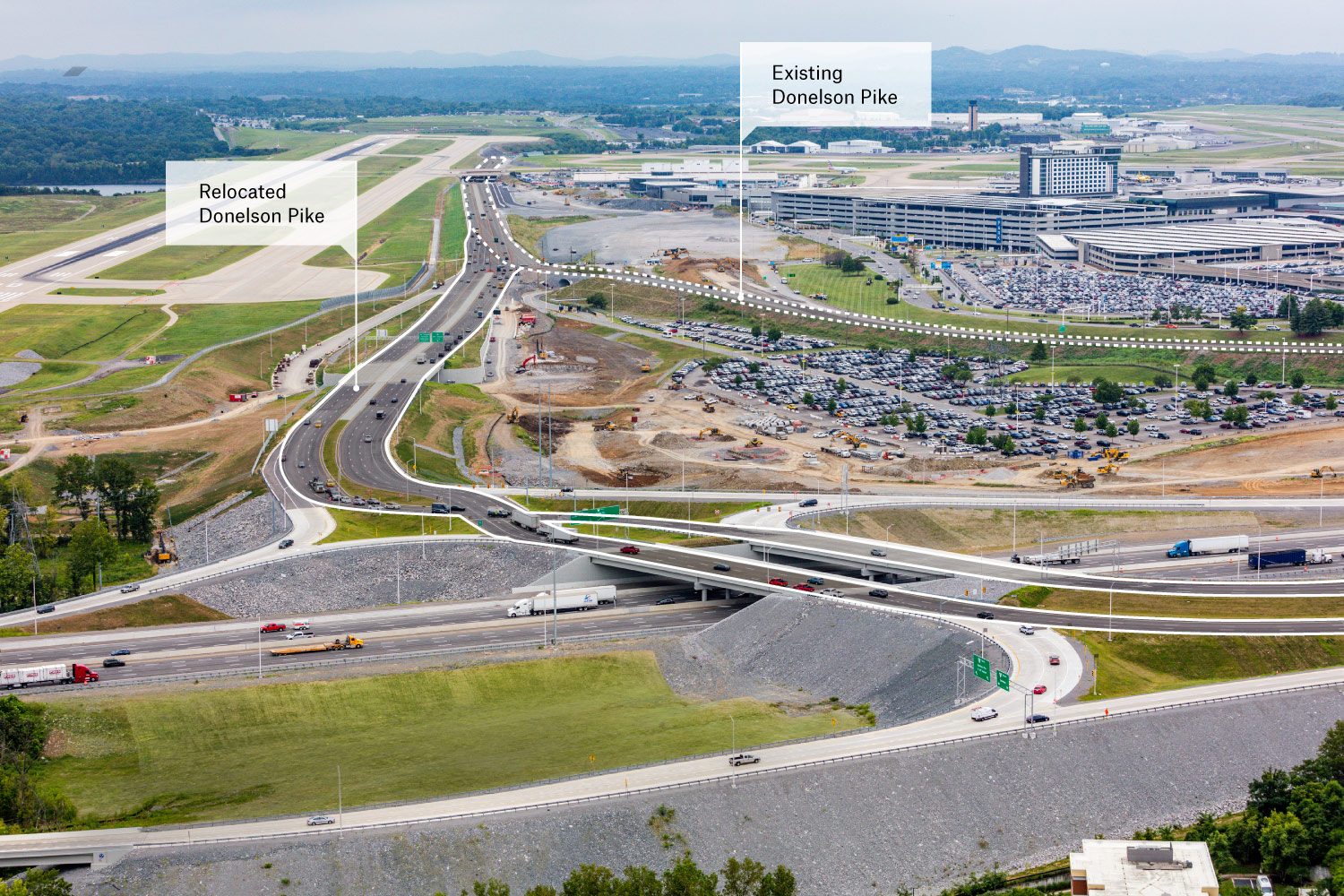

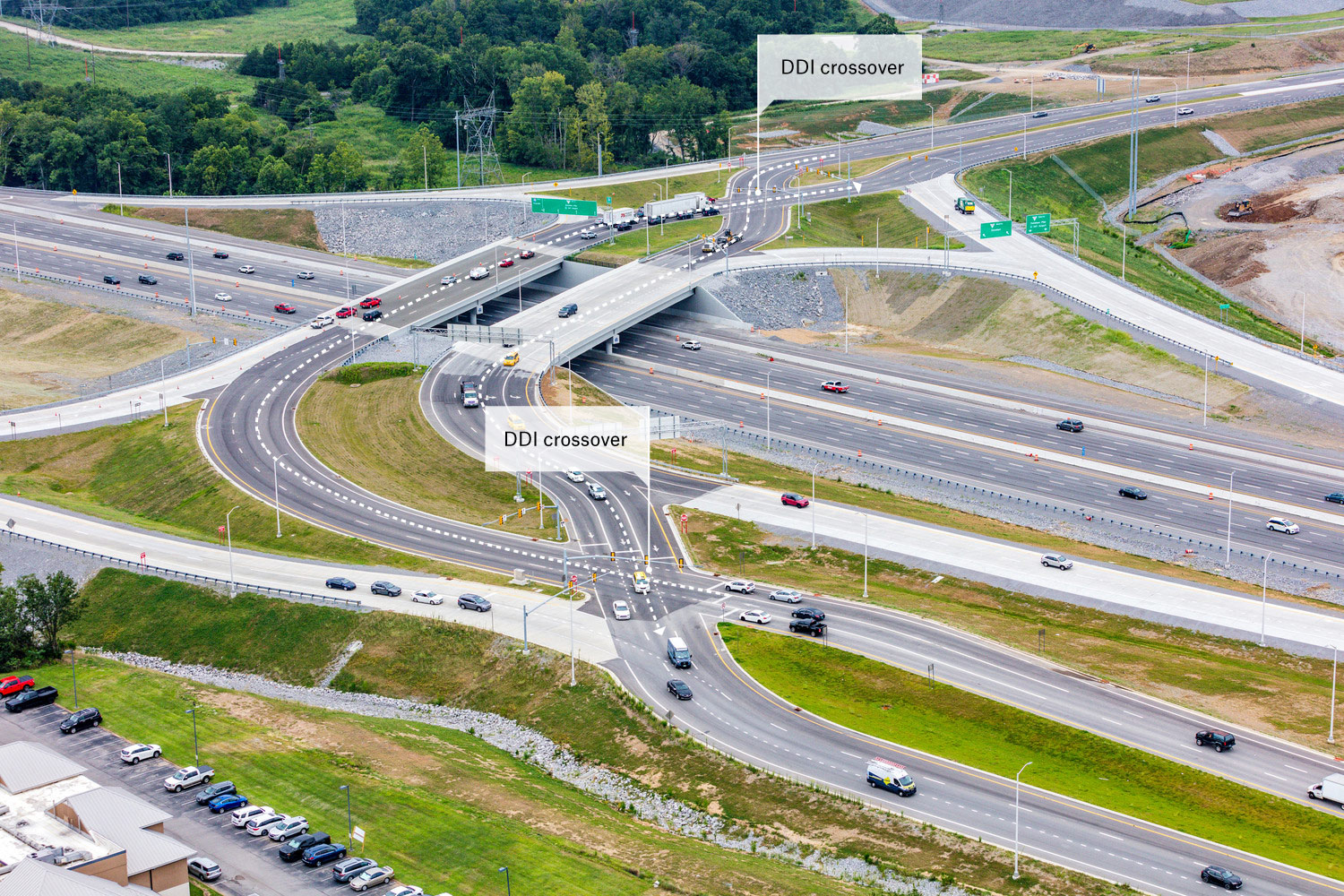

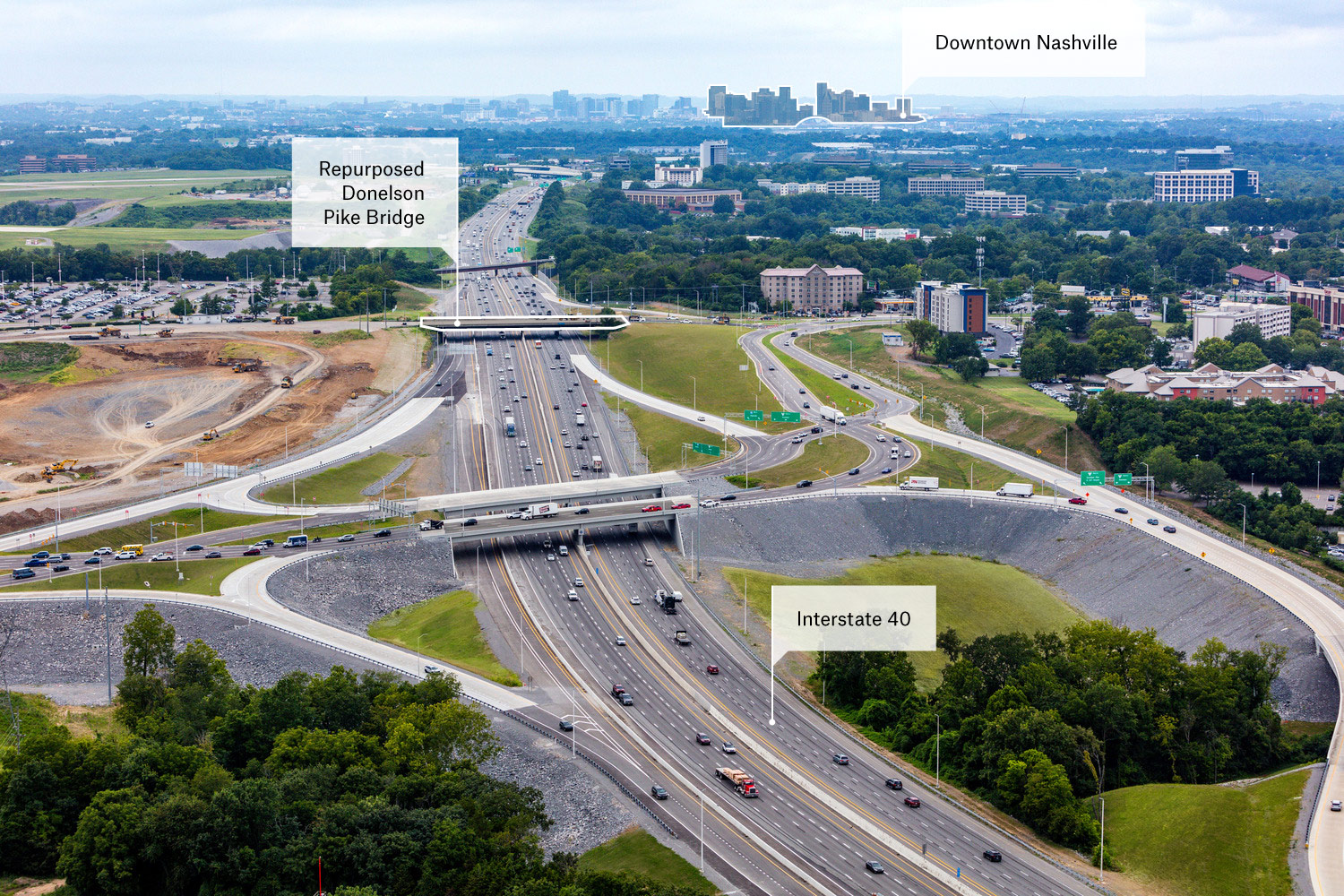

The new interchange, constructed with a complex DDI design, also relocated Donelson Pike to the east of the existing roadway. Today, the reconfigured roadway provides two to three lanes in each direction, with exit ramps diverging from through lanes and entrance ramps merging seamlessly. Two signalized intersections have been added at either end of the overpass to manage traffic movements. Additionally, four bridges were built: one north of I‑40 serving as the new westbound off‑ramp; the main dual bridges spanning I‑40 as part of the DDI; and another to the south, creating access in and out of BNA.

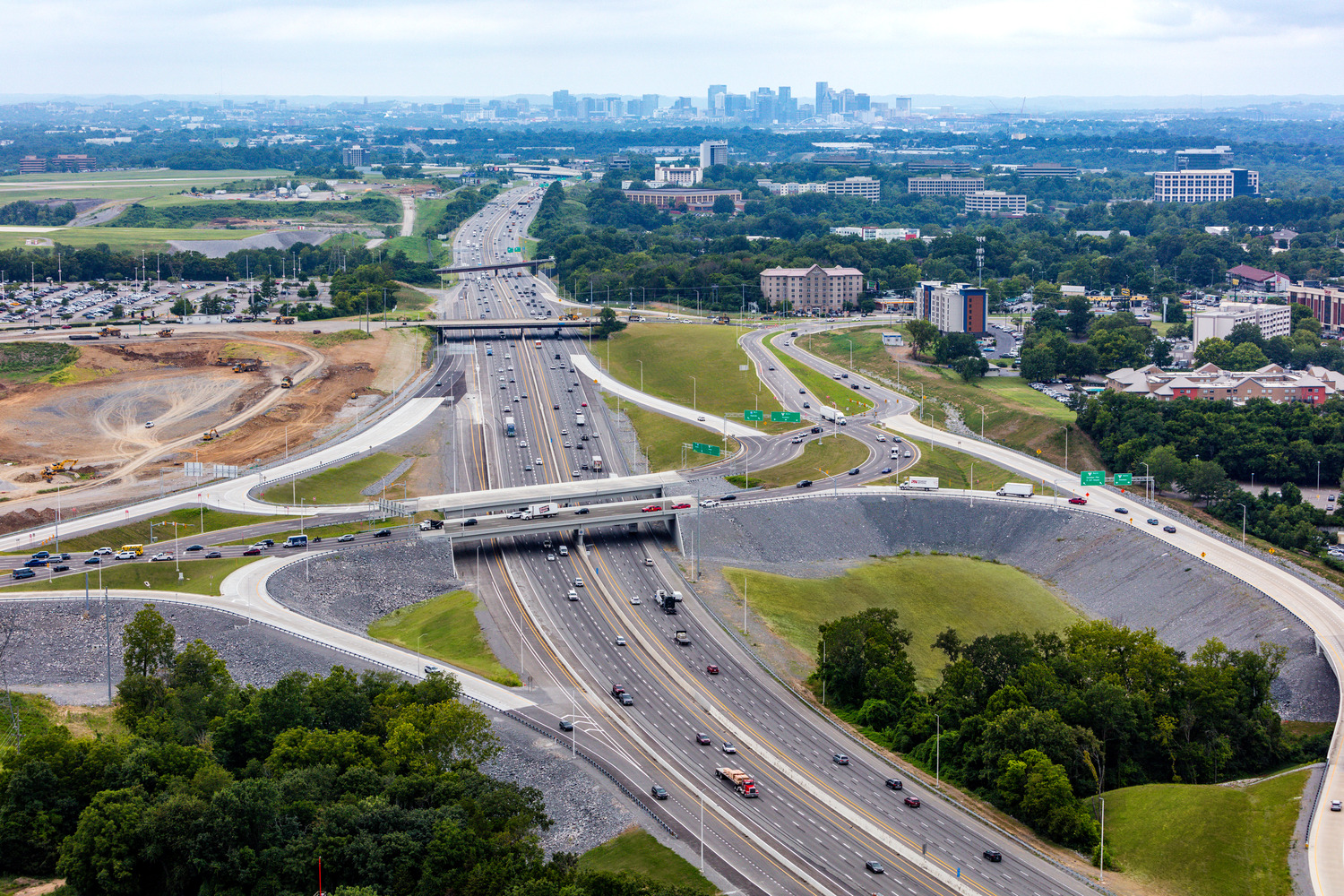

The completed diverging diamond interchange near the Nashville International Airport with Nashville skyline in distance

Designing a new interchange next to a fully operational international airport meant coordinating with the FAA, Air Traffic Control, and multiple stakeholders. The roadway alignment had to be geometrically precise: horizontal offsets to accommodate aircraft classifications, strict vertical controls to protect runway airspace, and line-of-sight studies to ensure no signage or traffic movement would interfere with critical air traffic control tower operations.

The project also involved an extraordinary level of utility complexity. Early planning identified potential schedule risks tied to relocation of TVA transmission towers, Colonial Pipeline petroleum lines, and communication infrastructure serving BNA.

The completed diverging diamond interchange near the Nashville International Airport with Nashville skyline in distance

The project was delivered on an extremely accelerated timeline. Because of the importance and the immense need for the project, the airport authority agreed to pay $6 million in incentives to the contractor for completing the project a year ahead of schedule. Ultimately, the project opened approximately 13 months ahead of schedule.

We have worked with Gresham Smith for over a decade on this important and challenging project that paves the way for the continued expansion at Nashville International Airport. This project lays the foundation for the ongoing growth and expansion of the airport, and it serves as an exciting and successful collaboration with TDOT and the Metro Nashville Airport Authority that will make a major impact on providing efficient access to the airport and the interstate. Shane Hester Chief of Engineering, TDOT
